Knowledge / Selection and temperature ranges
Dry Ice or Frozen Coolant Packs for Pharmaceutical Transport?
Dry ice and PCM frozen coolant packs fulfil different functions. Dry ice may be suitable where very low temperatures are required and permitted for the product. PCM −21 elements may be an option for a bounded range such as −15 to −25 °C. Changing the cooling medium requires a reassessment of the complete packaging.
Practical guidance
Check whether your product requires dry ice or can be shipped with PCM −21, including preparation and possible replenishment.

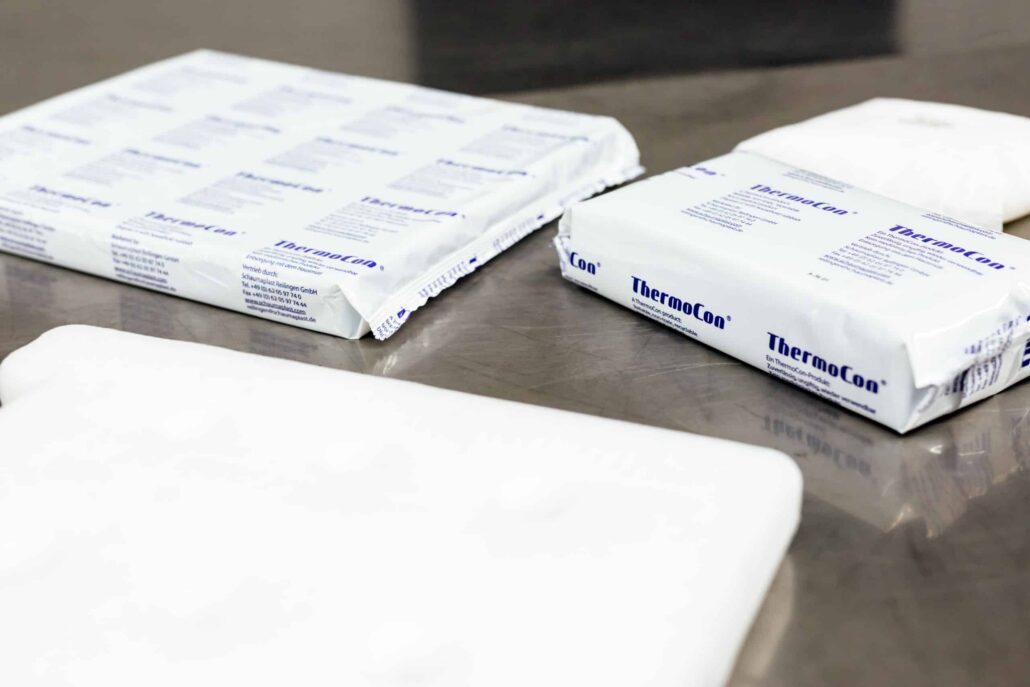

Foam bricks: depending on the item version, this rectangular format can contain water or PCM.
In this guide
- What is the lowest temperature the goods may reach?
- Dry ice and PCM −21 compared
- What to consider in the packout
- Record the dry ice quantity at packing
- Agree replenishment with everyone involved in advance
- Why a general consumption rate in kilograms per day is insufficient
- Include this information in the enquiry
What is the lowest temperature the goods may reach?
The requirement “frozen” is insufficient for selecting a cooling medium. Check whether a lower temperature limit applies as well as an upper limit. If the goods must not fall below −25 °C, for example, they are not suitable for direct dry ice use merely because they must travel frozen.
Dry ice is solid carbon dioxide. Under usual ambient conditions, it changes directly into gas. The packaging must allow this CO₂ to escape.
Dry ice and PCM −21 compared
Dry ice is an option for suitably low temperatures that the product can tolerate. Plan procurement, the quantity actually available at packing and gas release. The required amount depends on the tested configuration and transport.
PCM frozen coolant packs can support a bounded frozen range such as −15 to −25 °C. They must be prepared according to the system specification before packing. THERMOCON offers PCM −21 as Gelpack Pro, foam bricks and rigid-shell packs.
The −21 °C melting point does not guarantee a particular product temperature history. PCM −21 therefore does not replace a dry ice solution where substantially lower temperatures are required. The pharmaceutical thermal packaging guide identifies information needed to compare quotations.
Source: THERMOCON: PCM frozen coolant packs.
What to consider in the packout
- The product, dry ice and separating components must fit in the prescribed arrangement.
- CO₂ must be able to escape; the packaging must not be sealed gas-tight.
- Duration, ambient temperatures and opening events affect how much dry ice remains on arrival.
- If replenishment is planned in transit, the location, staff, material and procedure must be agreed before dispatch.
The FAA fact sheet describes hazards and packaging requirements for US air transport. For the specific shipment, also clarify the applicable dangerous goods rules and acceptance conditions with the carrier.
For larger shipments, access to and loading of the packaging also matter. The article on pallet shippers for pharmaceutical transport provides guidance.
Record the dry ice quantity at packing
Dry ice absorbs heat as it sublimates and leaves the shipper as gas. It also loses mass during preparation and waiting. The quantity stated by the supplier on delivery therefore does not necessarily equal the quantity inside the shipper when it is closed.
For an initial thermal estimate, the heat supplied can be divided by the usable enthalpy of sublimation. Enthalpy of sublimation describes the heat absorbed per unit mass during the transition to gas. This alone does not create packing instructions: distribution and residual quantity must adequately protect all relevant product positions.
Check the specified dry ice forms and positions, as well as the condition at the latest planned receipt time. If pellets are replaced with blocks, equal initial mass alone is not evidence of equivalence.
Agree replenishment with everyone involved in advance
“Replenish as needed” is insufficient during an extended customs delay. Who has access to the shipment? Is suitable dry ice available? Who may open the packaging, and how long may it remain open? How will the released CO₂ be safely dispersed?
The work instruction should define the replenishment criterion, checks on product condition and measurement data, added mass, timing and reclosure. Test this intervention as part of the transport process. For air transport, dangerous goods requirements and carrier conditions must also be agreed.
When considering a switch to PCM −21, first check the goods’ temperature requirements. Only if these can be met is it worthwhile comparing freezing capacity, preparation time, available product space and transport costs.
Why a general consumption rate in kilograms per day is insufficient
A larger shipper, different insulation or additional opening changes dry ice requirements. Use data for the intended configuration and account for planned delays. Dry ice that has sublimated before transport begins is no longer available later.
Document the quantity loaded and the time of packing. The article on qualifying thermal packaging explains how evidence for the complete packaging is established.
Include this information in the enquiry
Specify temperature limits, product dimensions and quantity, initial temperature, shipping duration, transport mode and intermediate stops. Add whether dry ice can be safely sourced and handled on site, or which freezers are available for PCM. This information helps select a suitable cooling medium and matching packout.
